Web App Development Cost Estimation: Complete 2026 Guide

04 Aug 2026

Web App Development Cost Estimation: Complete 2026 Guide

Summary

Web app development cost in 2026 ranges from $20,000 for a simple internal tool to $200,000+ for a multi-tenant SaaS platform.

  • Customer portals typically cost $30,000 to $80,000, and marketplaces run $40,000 to $150,000 at offshore rates.

  • Team location often explains cost differences more than complexity, the same portal can cost $30,000 in India versus $120,000 in New York.

  • Real-time features, multi-tenancy, or high concurrency can add 20-40% to a web app's total cost.

  • Year-one maintenance and hosting typically add 30-55% on top of the original build cost.

  • Offshore development rates in India run $20-55/hour, but the real loaded cost is often 1.4-1.8 times the quoted rate once management and onboarding are factored in.

A founder I spoke with last year had a number she trusted. Eighty thousand dollars, quoted by a good team, signed off by her board. Four months later the build was 60% done and the number had quietly become $134,000, because nobody priced what happens when three user roles need different permissions on one billing screen.

Nothing went wrong, exactly. The estimate was answering a different question than the one she was asking.

Most people asking "how much does a web app cost?" are not really after a figure. They want to know whether they can afford what they have in mind, what they would give up to fit a budget, and how badly month five will surprise them. A single number answers none of that.

So this guide does not give you one. It gives you six decisions instead. Work through them in order and you finish with your own range, a written list of assumptions, and enough understanding to tell a fair quote from an optimistic one.

The six decisions

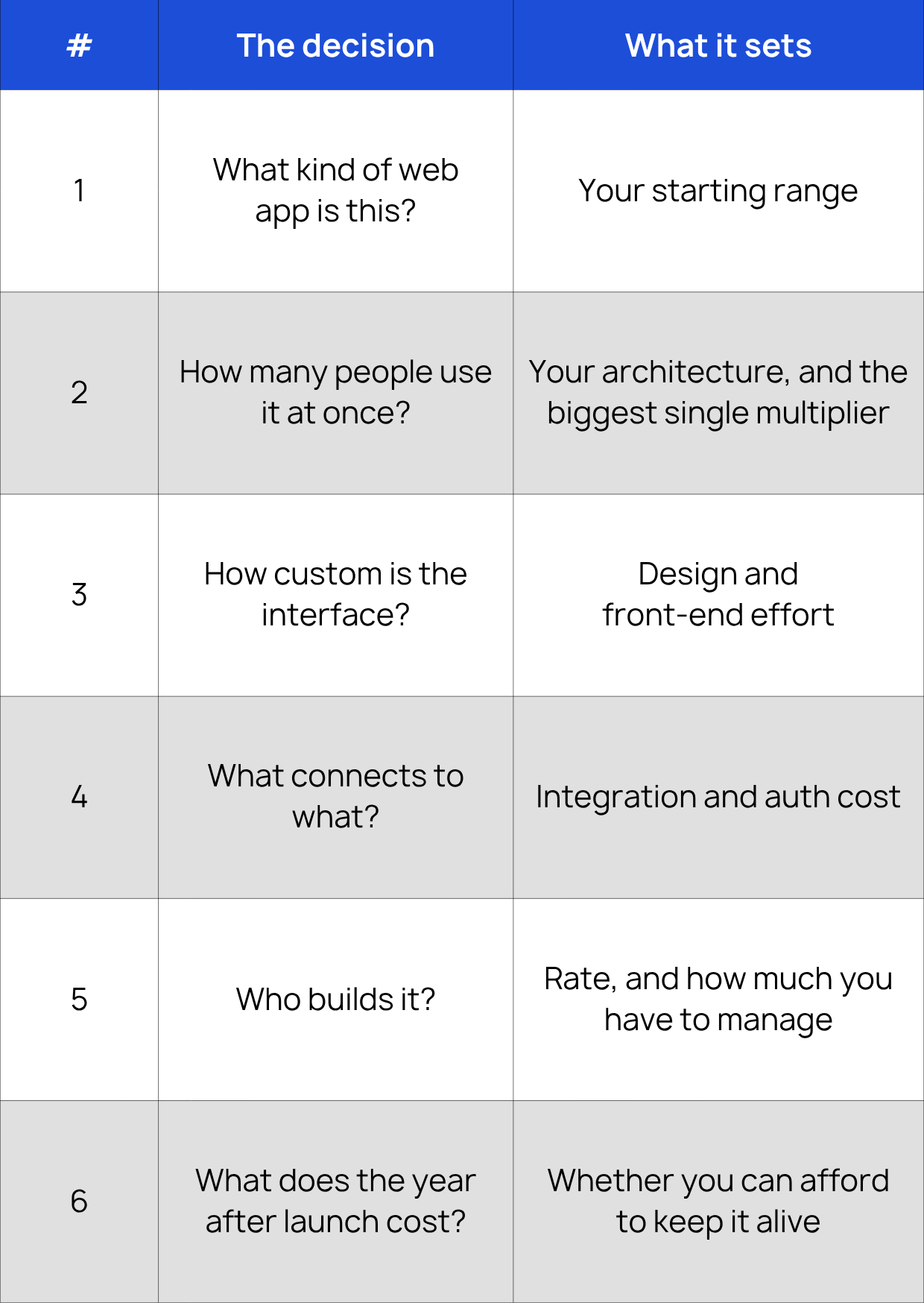

Web app cost is not one variable. It is six, and they compound rather than add. Answer them in this order, because each one constrains the next.

Web App Development Cost Estimation: Complete 2026 Guide

Keep a note open. Each section ends with the decision to write down.

Decision 1: What kind of web app is this?

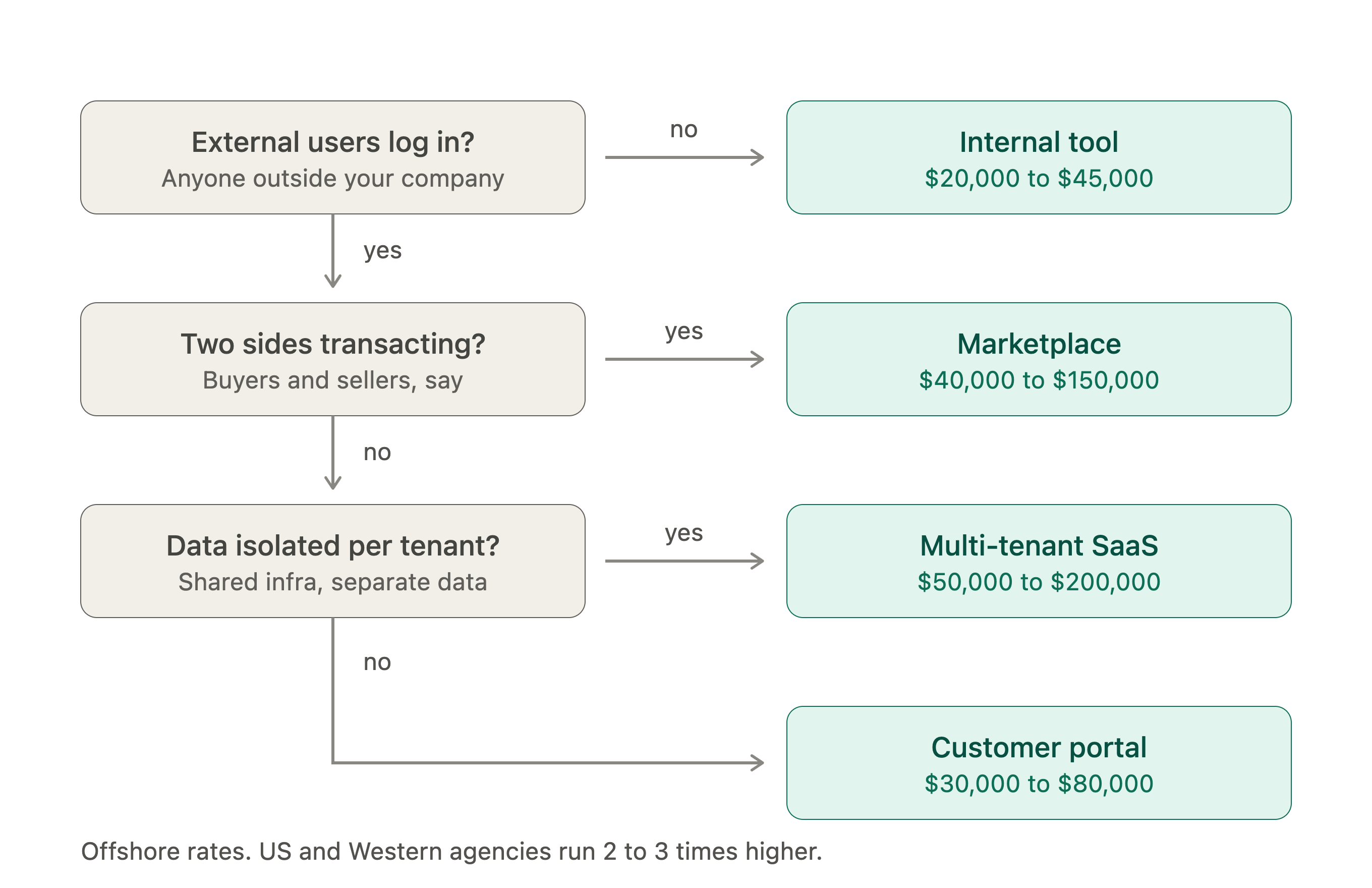

Web App Type Decision Tree

"Web app" is not a category with a price. It covers a four-page internal tool and a multi-tenant platform with paying customers, and those share a browser and nothing else.

Four types cover most of what gets built, and the type matters more than the feature count:

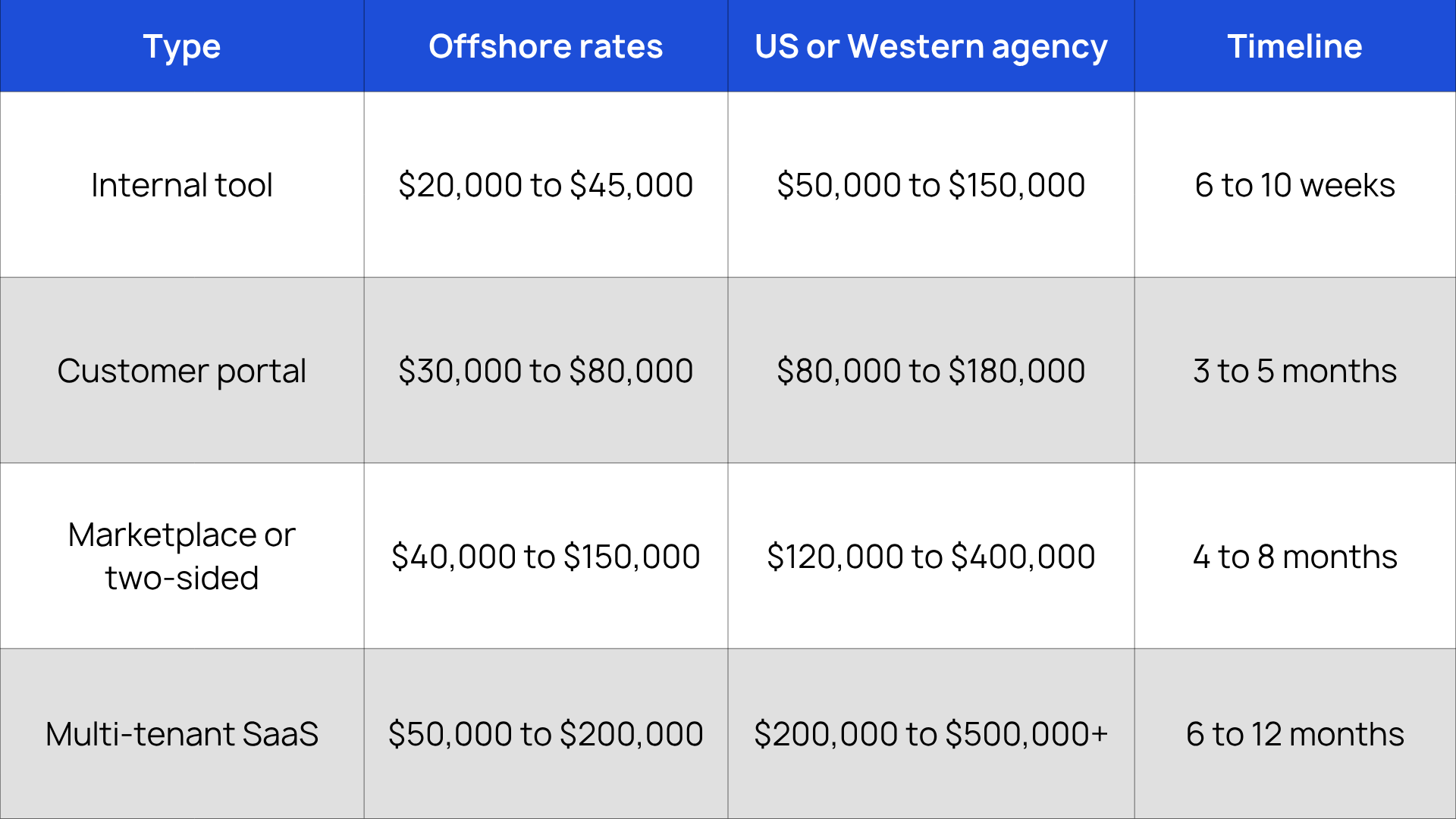

Web App Development Cost Estimation

An internal tool means one team and known users. A portal adds external accounts. A marketplace adds a second user type with matching, payments and disputes. Multi-tenant SaaS adds tenant isolation, billing and admin tooling.

Two things about this table matter more than the numbers in it.

Team location explains more of the spread than complexity does. The same customer portal is $30,000 built in India and $120,000 built in New York, and almost no published cost guide tells you which one it is quoting. When you compare two articles and get wildly different answers, this is usually why.

And the SaaS row is a range, not a price. A SaaS MVP with one workflow and basic billing runs $25,000 to $70,000. What pushes it to $200,000 is full multi-tenancy, seat management, proration and role-based access across an admin surface. Read the row you are actually in.

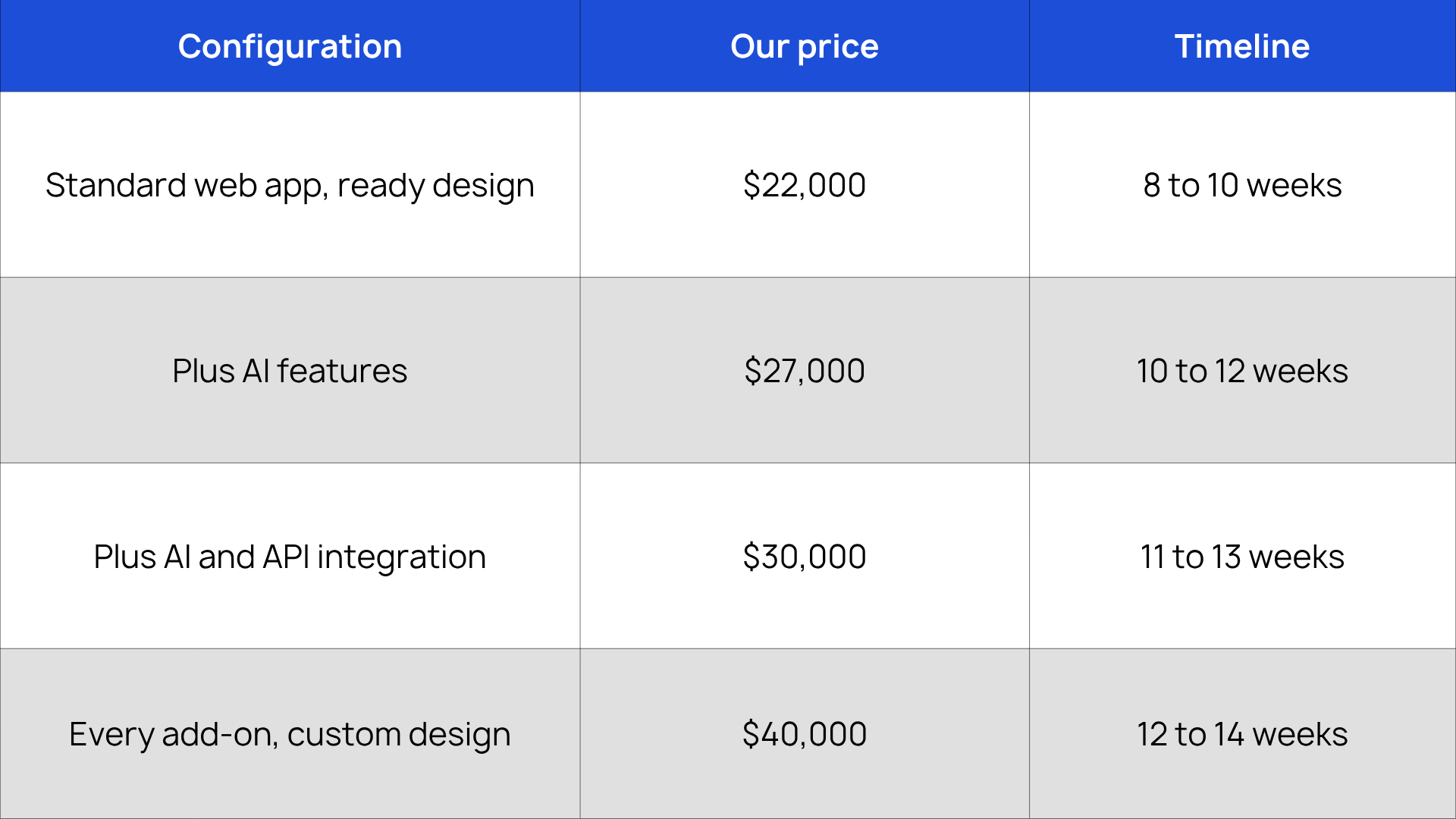

For comparison, here is what we actually charge. Our cost calculator prices a web app as a fixed-scope build, with authentication, a dashboard, billing, an admin panel and notifications already in the base:

Web App Development Cost Estimation

That ladder sits inside the offshore column above, and it is unremarkable there: The scope is fixed rather than open-ended, the baseline already includes what most quotes itemise separately, and it does not price Decision 2. If your app needs real concurrency, multi-tenancy or legacy integration, treat $40,000 as a starting point and read the portal or SaaS rows as your band.

Below roughly $20,000, real application work stops being possible. A quote under that means a freelancer, a low-code platform, or a scope narrower than a productised baseline. Genuinely small work is a website rather than a web app, which is why our website tier starts at $1,500.

The common error is pricing an internal tool while describing a portal. If people outside your company will log in, you are at least one row down this table, because external users bring password resets, support, onboarding, and a legal relationship with their data.

Write down: which of the four types you are building, and who logs in that does not work for you.

Decision 2: How many people use it at once?

This is the question that separates web app costing from software costing generally, and it is the one most quotes never ask.

A native mobile app runs on the user's phone. A web app runs on your servers, so every concurrent user is your cost and your risk. Ten simultaneous users and ten thousand are not the same product even with an identical feature list. The second one needs connection pooling, caching, read replicas, queue-based background jobs, and a load testing budget. None of that is visible in a demo.

Concrete version. A dashboard is a screen with charts. Or it is a permissions model, an audit trail, a caching layer, and a data pipeline that stays correct when two admins edit the same record eight seconds apart. Same demo, very different cost.

Three things push you up a tier here, and each is web-specific:

  • Real-time anything. Live chat, notifications, collaborative editing or presence indicators mean websockets, which means connection state, reconnection logic and a scaling model most teams get wrong first time.

  • Multi-tenancy. Shared infrastructure with hard data isolation between customers. This is architectural, not a feature, and it is close to impossible to retrofit.

  • Background processing. Reports, imports, exports and scheduled jobs need a queue and a worker tier, doubling the surface you deploy and monitor.

Expect the concurrency and real-time layer to add 20 to 40% over the same app built for light internal use. On the EV charging platform we built for 5,000+ stations, live station status was a larger engineering line than the entire customer-facing booking flow.

Write down: your expected peak concurrent users in year one, and whether anything has to update without a page refresh.

Not sure which architecture your traffic needs? This is the decision no calculator can make for you, and the one that most often separates a $60,000 quote from a $160,000 one. A 30-minute call with an engineer is usually enough to settle it. Talk to our team →

Decision 3: How custom is the interface?

Web apps are measured against the open web: search engines index them, any browser can open them, enterprise buyers can audit them. A front-end budget covers those standards, so it helps to know which apply to you.

You are paying for four things most quotes fold into one line called "UI":

Design depth. A component library with light theming is cheap. A bespoke design system with custom interaction states is not. Market spreads between the two run 2 to 3x on identical screens. Our own calculator applies a flat 25% uplift for custom design over a ready one, which is what a fixed-scope version of that decision looks like.

Breakpoints. Every screen exists at desktop, tablet and mobile widths. That is not one design, it is closer to two, and QA multiplies with it.

Browser matrix. Supporting current Chrome, Safari, Firefox and Edge is standard. Adding older Safari or corporate IE-mode requirements can add 10 to 15% to front-end effort.

Performance and accessibility. Interaction to Next Paint at or below 200ms is the current Core Web Vitals target- Google's current speed benchmark, and WCAG 2.2 AA is the accessibility level buyers now ask for. Both cost less built in than retrofitted.

The design phase itself typically runs 10 to 20% of build cost. Skipping it does not save that, it moves it into rework at a worse rate.

Write down: how many unique screens you need, how many breakpoints each must work at, and whether you have a design system or need one.

Decision 4: What connects to what?

Integrations are where estimates quietly break, because each one arrives with someone else's rules.

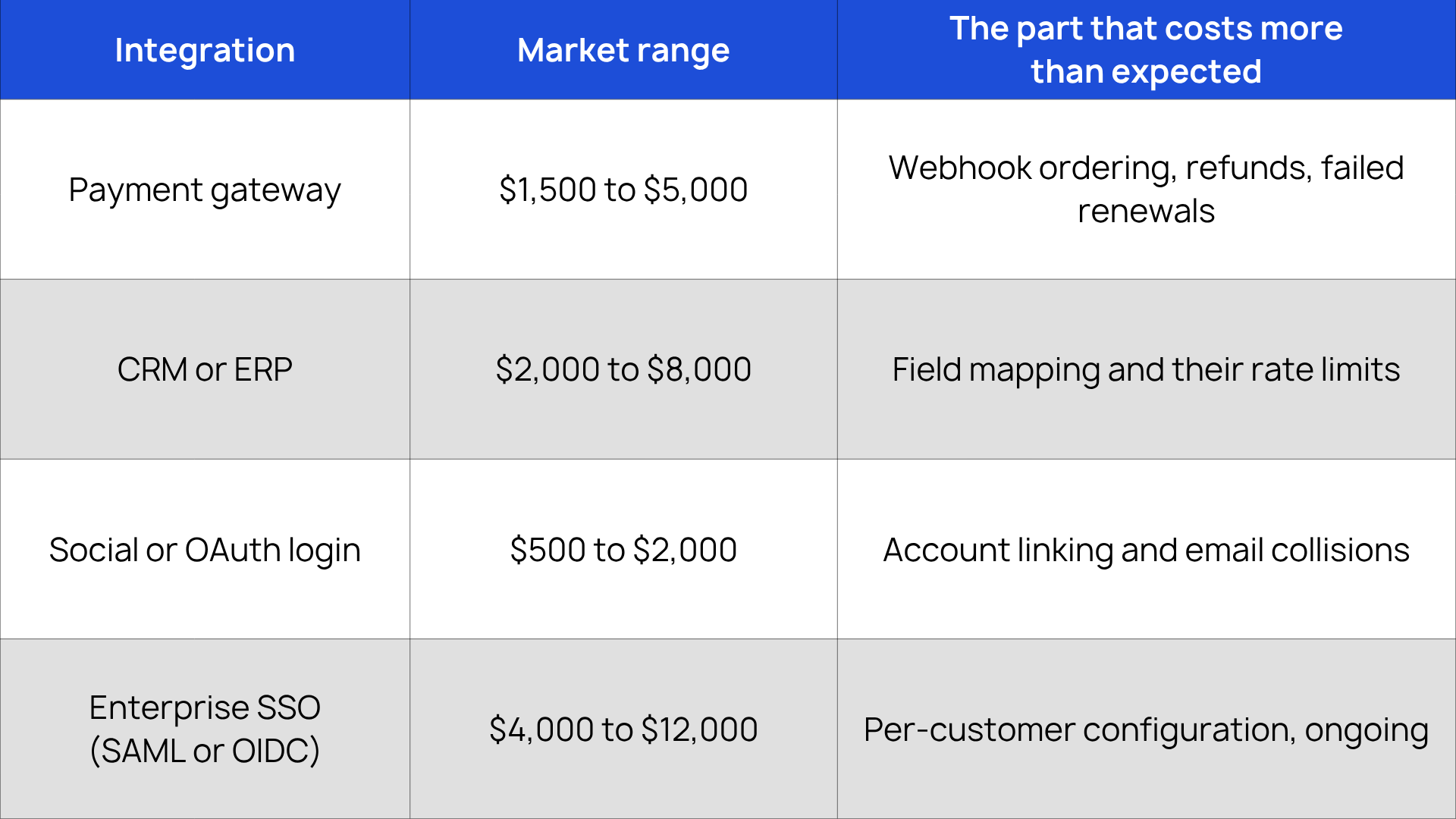

Web App Development Cost Estimation

Two web-specific notes. Enterprise SSO is not a one-off: every enterprise customer needs their own setup, so it becomes a support cost as well as a build cost. And if a mobile app is on your roadmap, building API-first now costs a little more and saves a rewrite later, which is worth reading alongside our mobile app development guide.

On our calculator, AI features add $5,000 and a standard API integration $3,000, with the full add-on set capped at $10,000. Those prices hold because the work is well defined. The wider ranges above cover the harder cases, like SSO configured per customer or a CRM whose field mapping nobody has seen yet. Scoped precisely, an integration can be quoted upfront; left open, a range is the honest answer.

Authentication deserves its own mention because it is the most consistently underpriced item in web app quotes. Email and password login is 16 to 24 hours of full delivery. Email login plus reset, session expiry, account lockout, SSO for enterprise customers and role-based access across a dozen screens is a different feature wearing the same name, and it is measured in weeks.

Write down: every external system you will connect to, and whether any customer will demand SSO in year one.

Decision 5: Who builds it?

This decision sets your rate, but rate is not cost.

Published 2026 rates put India at $20 to $55 an hour with a median near $32, Eastern Europe and Latin America higher, and US or Western European agencies at two to three times that. What the rate card hides is that several 2026 surveys put the true loaded cost of offshore work at 1.4 to 1.8 times the quoted rate once management, ramp-up and attrition are counted.

So the real variable is how much architectural ownership sits on your side of the table. A $25 an hour team that needs you to make every technical decision costs more than a $60 an hour team that makes them well. If you are evaluating partners, our guide on what to check before hiring a software company covers the diligence questions, and we maintain a review of web app development companies for startups.

Your engagement model matters as much as your region:

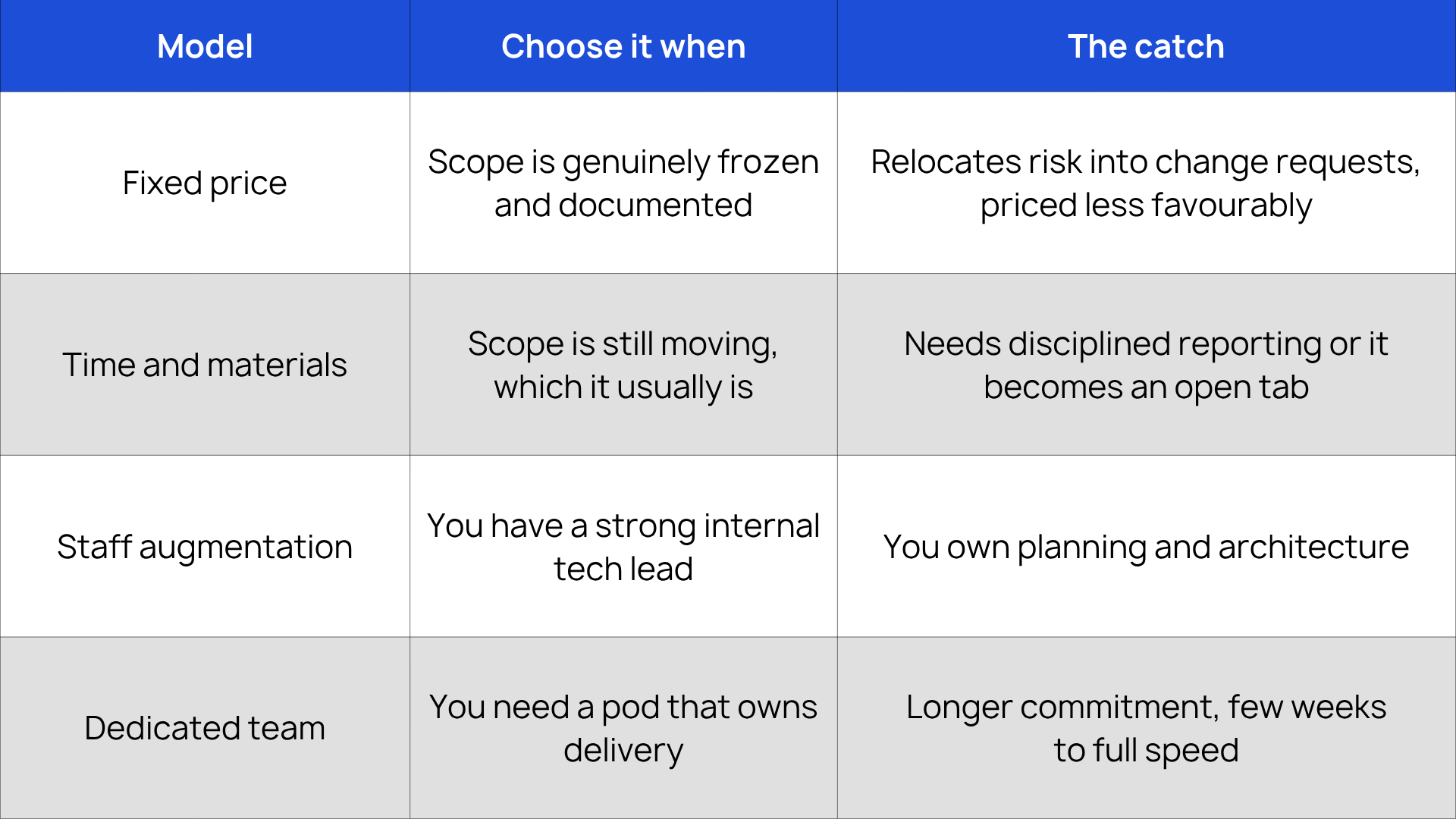

Engagement Models

Fixed price feels safest to first-time buyers and rarely is. It is safe only when scope is frozen. Otherwise every discovery becomes a negotiation.

Write down: your model, your region, and who on your side owns technical decisions.

Decision 6: What does the year after launch cost?

Build cost is what you negotiate. Total cost of ownership decides whether the product survives.

Absolute figures are misleading here, because a $12 managed database and a $2,000 one are both "infrastructure." Ratios travel better, so price these against your build:

Decision 6: What does the year after launch cost?

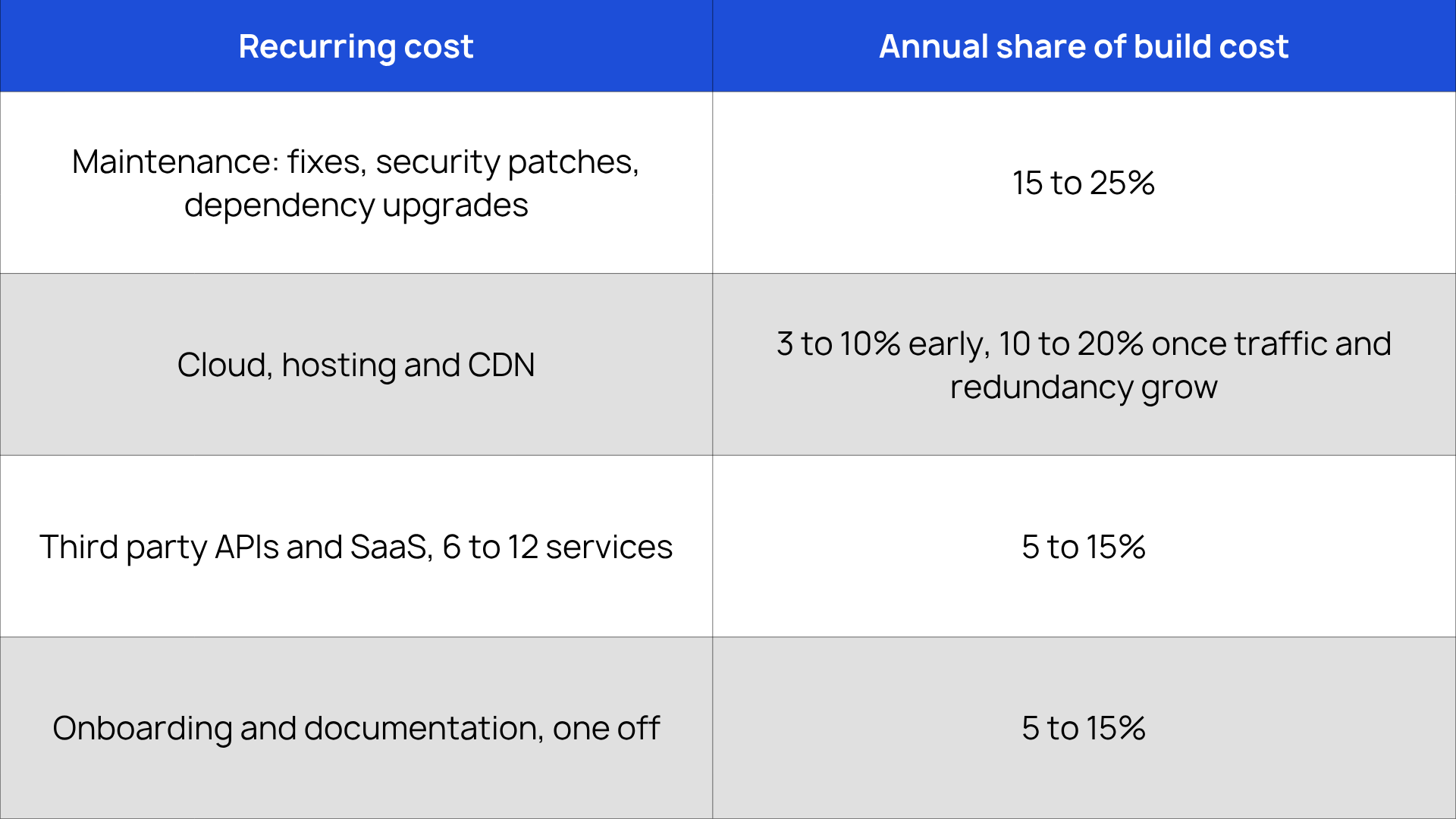

Don't add the top of every row together; they rarely peak at once. In practice year one costs 30 to 55% of the build. So if you raised just enough to build, you raised about 70% of what you need.

Our own support plans bracket that. $600 a month on a web app is 18% of a $40,000 fully loaded build but 33% of a $22,000 standard one, so the leaner the build, the heavier maintenance weighs against it.

Write down: your build estimate multiplied by 1.4. That is your realistic 18-month number.

Now add it up

You have six answers. Turn them into a range.

  1. Start with your type from Decision 1.

  2. Add 20 to 40% if Decision 2 involves real-time, multi-tenancy or serious concurrency.

  3. Add 10 to 20% for a custom design system, or nothing if you are theming a component library.

  4. Add your integrations from Decision 4 as line items, not a percentage.

  5. Adjust for region, then apply the 1.4 to 1.8 loaded multiplier if the team is offshore and you are not supplying a tech lead.

  6. Multiply the total by 1.4 for the first 18 months.

Two numbers, not one: a floor if everything is straightforward and a ceiling if the unknowns land badly. If the gap between them is more than 2x, you have found the thing you do not understand yet, and that is worth a discovery conversation before a contract.

Use the calculator to check your maths

You have just done this by hand. Our software development cost calculator does the same arithmetic in four steps, project type then features then design then support, with the estimate updating as you answer.

The maths is not hidden: it takes your base price, adds your selected features, multiplies by a design factor, and returns a fixed price with a timeline rather than a range. A web app runs $22,000 to $40,000, a marketing website $1,500 to $3,400, a mobile app from $28,000.

It is free and there is no form in front of the result. Use it even if you are shopping elsewhere: a written estimate is the single most useful thing to have in hand when you compare quotes.

Get your estimate in four steps Project type, features, design, support. Fixed price and timeline at the end, no email required. Open the cost estimator →

What it will not price is multi-tenancy or legacy integration, which is Decision 2 and exactly the material that needs a conversation. For a broader view across project types, our custom software development cost guide and software development cost estimation guide go wider than web apps.

How to read an agency quote

Now use the six decisions as a test. A quote worth trusting answers all of them; a quote that worries you is silent on three or more.

  • Does it state expected concurrent users and say what happens beyond that number? (Decision 2)

  • Does it separate design from front-end build, and name the breakpoints and browsers? (Decision 3)

  • Are integrations priced individually, or bundled as "third party integrations"? (Decision 4)

  • Does it name who makes architectural decisions? (Decision 5)

  • Does it include QA and documentation as costed work? Across the market, development is 30 to 50% of project cost, testing 15 to 20%, documentation 10 to 25% and project management 5 to 20%. A quote where development is 85% of the total has either omitted work or plans to skip it.

  • Does it state a maintenance figure for year one? (Decision 6)

Also ask what assumptions the number rests on. If nobody can argue with the assumptions, they are not specific enough to be useful.

If the number is too big

The instinct is to cut features. Cut scope instead, which is not the same thing.

Ship one user role and one complete flow rather than four half flows. Narrow beats broad-and-almost-working, and it is the difference between an MVP and a demo.

Blend seniority rather than buying it uniformly. A senior plus mid structure typically saves 20 to 35% against an all-senior team, and on well-architected work the output gap is smaller than the invoice gap.

Buy instead of building the boring parts. Auth0, Stripe and a managed database cost monthly fees and save months. Replace them later if scale justifies it, which it often will not.

Spend more on architecture, not less. It is the line item that most reliably pays for itself, because the expensive rewrites all trace back to a decision made in week two.

Freeze scope per sprint. PMI puts the average scope creep overrun at 27%, so a written change process is the highest-return control you have.

What changed in 2026

AI is now part of how software gets built, not just something you add to it. That pulls your cost in three directions at once.

It makes routine work faster. 20 to 40% off predictable work — standard screens, forms, test scaffolding. Barely helps with multi-tenancy or permissions, because the difficulty there was never the typing.

It makes AI talent expensive. PwC found AI skills earn 62% more, up from 56%. Ordinary tech pay is flat next to that. So developers haven't got more expensive — AI developers have.

It has pushed up hosting. Memory makers moved production toward AI hardware, DDR5 rose 307%, cloud providers are passing it on.

FAQ

How much does it cost to build a web app in 2026?

It depends on type and on where the team sits. At offshore rates, internal tools run $20,000 to $40,000, customer portals $30,000 to $80,000, marketplaces $40,000 to $150,000 and multi-tenant SaaS $50,000 to $200,000. US and Western agencies run roughly two to three times higher. Our own fixed-scope builds are $22,000 to $40,000, covering the first two rows with no heavy concurrency work.

Why do two quotes for the same app differ so much?

Usually because they assume different answers to Decision 2. Concurrency, real-time behaviour and multi-tenancy can double a build without changing a single screen. Compare assumptions before comparing prices.

What is the biggest hidden cost?

Maintenance, at 15 to 25% of build cost annually. Hosting and third party subscriptions are second. Together they add 30 to 55% of your build in year one.

Does offshore development actually save money?

Often, but less than the rate suggests. Published 2026 India rates run $20 to $55 an hour, while loaded cost lands at 1.4 to 1.8 times the quoted rate. The saving is real when you are not also supplying the architecture.

Should I choose fixed price or time and materials?

Fixed price only if your scope is frozen and documented. Otherwise time and materials, because fixed price on moving scope relocates risk into change requests rather than removing it.

How long should estimation take?

One to two weeks of discovery for a mid-size app. A complex platform quoted in 48 hours is pattern matching to a previous project, which is a starting point rather than an estimate.

Can I get a number without talking to anyone?

Yes. The cost calculator returns a fixed price and timeline in four steps with no form in front of the result.

Ready to Put a Real Number on Your Web App?

The difference between projects that finish near their estimate and those that double isn't budget or team size - it's answering the six decisions above before signing, not during month four. MTechZilla has built web platforms across travel, real estate, insurance, energy, education and government since 2021 - we know which of the six gets skipped most often and what it costs later.

Two ways to start, depending on what you need.

Calculate your web app cost → - a fixed price and timeline in four steps, no email required.

Contact us → - if your answers to Decision 2 or Decision 4 need a conversation before a number means anything.
